Construction Project Management in Mauritius
For multi-trade projects, BFC Ltd takes the coordination, the programme and the cost control off your desk and runs the site as a single accountable manager.
What we deliver
- Scope definition, programme and sequencing
- Contractor selection, briefing and coordination
- Cost control and management of variations
- Site supervision and stage quality checks
- Safety and regulatory compliance oversight
- Snagging, handover and as built documentation
How we work
Projects rarely fail on technical difficulty. They fail because nobody owned the sequence, the variation was agreed verbally, or the inspection happened after the work was covered up. Our role is to close those gaps and to keep a written trail of decisions.
You get a single programme, regular progress reporting against it, and early warning when something threatens the date or the budget. That gives you time to decide rather than being told after the fact.
What we take off your desk
Most clients who ask us to manage a project are not short of contractors; they are short of time and of a single point of accountability. Project management here means we hold the programme, coordinate the trades, check what is being built against what was priced and drawn, verify quantities before they are certified for payment, and tell you early when something is heading off track rather than explaining it afterwards.
Practically, that includes preparing or reviewing the scope so tenders are comparable, running the site so trades do not block each other, keeping a written record of instructions and variations, inspecting work at the stages that matter — before things are covered up — and managing the snagging and handover so the last ten per cent does not drag on for months. You get short, regular progress reports with photographs and a clear view of cost committed against budget.
A worked example: ten days on a ground floor slab

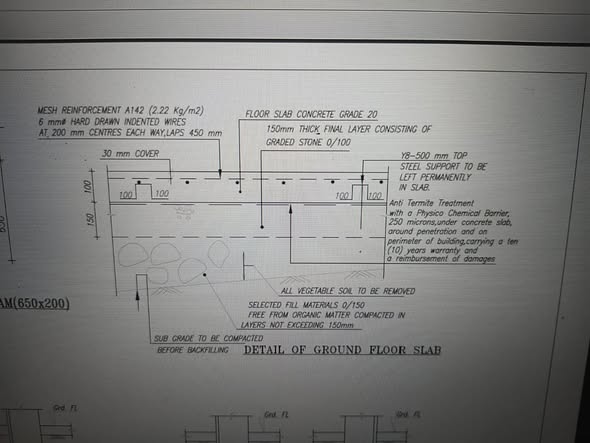

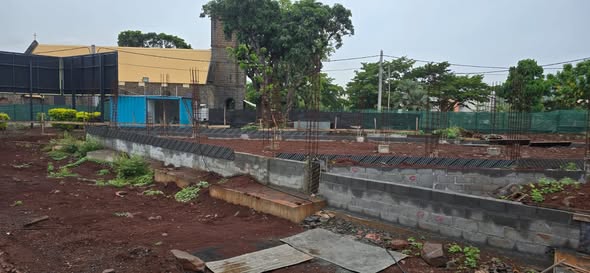

A useful illustration of what project management actually buys you is the ground floor construction at the Terre d'Ete siege social in Petite Riviere, which we delivered as a subcontract for builder's work in ten calendar days, on time and on specification. On paper it was a simple package: site preparation, hardcore and crusher run compaction, an anti-termite membrane, mesh and formwork, the concrete pour and quality control throughout. In practice a ten-day programme on a slab leaves no slack anywhere, which is exactly why it needed managing rather than merely supervising.
The sequence was fixed backwards from the pour. Compaction had to be signed off before the membrane went down, the membrane had to be laid and protected before steel and formwork traffic crossed it, and the reinforcement and formwork had to be inspected and released before concrete was ordered, because a rejected pour on day eight has no recovery route. Materials were called off against that sequence rather than delivered early and left to sit on a working area. Each hold point was inspected and photographed, so the client could see compliance rather than be told about it. The result was a slab that passed inspection first time and a client who was never asked for a decision at short notice.
Where projects actually go wrong
Across the projects we take over mid-flight, the causes repeat. Nobody owned the sequence, so two trades arrived for the same area on the same morning and one of them left. A variation was agreed verbally on site and surfaced eight weeks later as a disputed invoice. An inspection happened after the work had been covered up, so verification became demolition. Long-lead materials were ordered after the programme was issued rather than before it. And the last ten per cent - snagging, commissioning, as-built information - had no owner, so handover dragged on for months after the works were substantially complete.
None of those are technical failures. They are management failures, and they are the reason the cost of formal project management is usually recovered several times over on a multi-trade job. Our role is to close those gaps and keep a written trail of every decision, so that at the end you hold a set of records rather than a set of recollections.
What you receive during the works
Short written progress reports at agreed intervals, each with photographs, work completed measured against the programme, cost committed against budget, a variation register with status, an inspection log, and a clear list of the decisions we need from you with the date each is needed by. Quantities are verified on site before they are certified for payment. At completion you receive the snagging list with sign-off, commissioning records, warranties and as-built documentation.
What our clients say
“BFC Ltd handled our office relocation and fit-out with impressive precision. From the initial layout planning to the final IT reinstallation, every step was well-sequenced and professional. It was great to deal with a single team that understood our timeline and delivered a high-quality finish without the usual project management headaches.”
Related reading
If your project is a fit-out, the cost drivers are set out in office fit-out costs in Ebene. If you are weighing a managed maintenance programme against ad-hoc repair, see AMC versus reactive maintenance.
Recent work



Coverage across Mauritius
BFC Ltd operates from Quatre Bornes and carries out construction project management island wide, covering Port Louis, the central towns of Curepipe, Rose Hill, Vacoas and Phoenix, the north and the coastal districts. Commercial, industrial, retail and residential properties are all served.
Frequently asked questions
Can you manage a project where another contractor does the building work?
Yes. We can act purely in a management and supervision role, coordinating and inspecting other contractors on your behalf, which keeps the roles clearly separated.
What size of project is worth managing formally?
Anything with several trades, a fixed deadline or a client who cannot be on site regularly. Even a modest renovation benefits, because most cost overruns come from sequencing and late decisions rather than from rates.
How do you report progress?
Short written reports at agreed intervals, with photographs, work completed against programme, cost committed against budget, and a clear list of decisions we need from you and by when.
Planning construction project management in Mauritius. Send us the site location, the scope of works and your timeline, and we will come back with a written quotation.
Or call and WhatsApp +230 5724 5224
